20entry
Renovating an existing practice while it stays open
Stage by stage 07/09/2026revised Buildphase

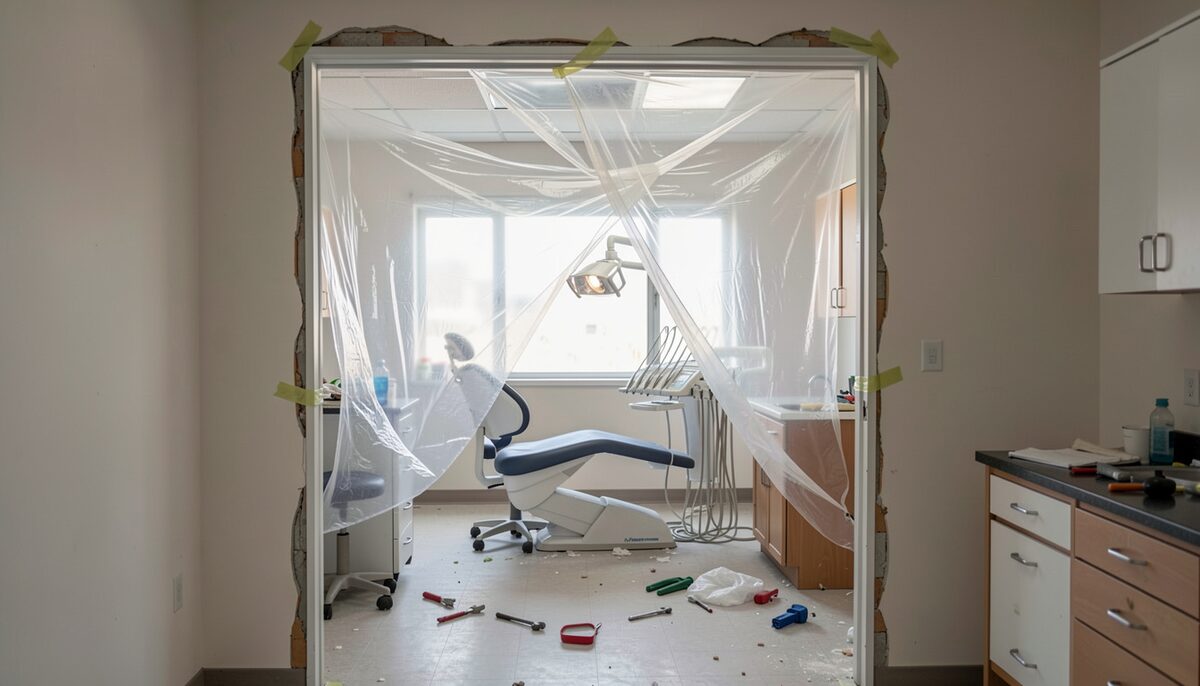

A half-demolished operatory with sheeting taped across the doorway. Pacific Northwest. Illustration produced for The Operatory.
Plate 3:2 · the room seen from the door
Renovating an existing practice while it stays open. How to renovate an existing dental practice while it keeps operating, covering phasing, temporary spaces, utilities and dust control.
How this entry is measured
- Every figure is read from a named code, standard, planning sheet or public register, and it is named where the figure appears.
- Areas and clearances are given as ranges: the number of chairs, the lease and the equipment set move them.
- Nothing here ranks a firm, a clinic, a supplier or a plan.
Contractors do not publish bid spreads, and no public source gives a regional cost per square metre for a dental fit-out.
You can renovate a dental practice while it stays open, but only if the project is planned around the clinical day rather than around the contractor's schedule. Treatment rooms come back online in stages, the quiet work happens after the last patient leaves, and every shutdown of water, suction or power is booked like an appointment. Planning a renovation this way is one of the many things covered under practice management guidance for renovating a dental practice, and the sections below set out what that means on site.
1. What stays running during a renovation?
Not everything has to stop. A practice usually identifies one or two treatment rooms, a sterilization area and a reception point that must remain functional at all times, and everything else becomes the work zone. The rooms farthest from the entrance are the easiest to hand over first, because patients walking to a working operatory never pass through demolition. The boundary between the two zones is a wall, a temporary partition or a zip wall, and it is decided before anyone swings a hammer. The more clearly that line is drawn, the less the clinical team has to think about it during a working day.
Staff who normally work inside the affected rooms are not left without a role. They move to the rooms that stay open, help with scheduling around reduced chair capacity, and take on the cleaning and set-up that temporary layouts demand. Front office staff field the calls that would otherwise be about noise, parking or a changed entrance.
2. Phasing options: staggered rooms, wing by wing, or a full relocation
There are three broad ways to sequence the work. The first is staggered rooms, in which one operatory is closed and rebuilt while the rest carry the schedule. The second is a wing by wing approach, where half the practice closes for a concentrated phase and the other half absorbs the patients. The third is a full move of clinical activity into a temporary space while the permanent suite is rebuilt in one hit.
The choice follows the practice's patient volume and its tolerance for a reduced schedule. Staggered rooms stretch the disruption across many weeks but never take the practice offline, and they suit a clinic that has spare chair time. A wing by wing phase is shorter and more disruptive, and it tends to suit a practice that can compress its bookings for a defined window. A full relocation is the cleanest for the builder and the most disruptive for the practice, because a whole clinic has to be operating somewhere else while the permanent one is out of action.
How the trades are ordered inside each phase matters as much as the phase itself. Details on that are set out in the guide to sequencing the construction.
- What the code requires
- Permit drawings, inspections and the certificate of occupancy are set by the authority having jurisdiction, not by the design team or the contractor.
- What the manufacturer specifies
- Equipment lead times are published by each supplier and move with the order book, so they are checked again at the start of construction.
- What is not published
- Contractors do not publish bid spreads, and no public source gives a regional cost per square metre for a dental fit-out.
3. Where do you put everything while treatment rooms are closed?
Healthcare work needs somewhere that is legally, practically and clinically acceptable. The clinical standards that apply in a permanent suite do not disappear because the suite is temporary, to a rehearsal of the registration requirements in the permanent finished practice. If the practice does not have spare rooms on site, the options are typically a second location, a temporary clinic build inside a larger shell, or a staged use of the rooms that remain. Each choice changes the schedule: a second location adds travel and set-up time, a temporary build adds months of mobilisation, and staggered rooms add chair downtime.
Sterilization deserves its own plan, because instruments cannot queue behind construction. If the sterilisation counter is being rebuilt, a working reprocessing corner has to be established somewhere else first, with the same separation of dirty and clean flow that the permanent room will have. When the sterilizer itself is being moved or replaced, that work belongs in the same sorted list as equipment shutdown windows, rather than being discovered mid-week. With no specific OSHA standard for dentistry, the general industry standards for bloodborne pathogens and chemical hazard control are what a temporary set-up is measured against, and the OSHA dentistry overview lists those hazard categories for dental workplaces.
4. How do you move chairs and utilities without shutting the clinic?
Dental chairs are the hardest item to move and the easiest to forget in a programme. A chair needs compressed air, water, suction and power, and none of those can be improvised safely. The practical sequence is to take the chair out of service, disconnect and cap the services in a planned window, move the chair, reconnect it, and only then return that room to clinical use. Two rooms sharing a wall often share a service run, which means one shutdown can take both rooms offline at once unless the plumbing is re-routed first. Utilities are usually the reason a renovation cannot be phased freely: the wall that has to open is the wall that carries the supply.
Electrical work is similar. If the panel has to be extended or a sub-panel added, the circuit change is a planned outage, not a surprise. The same goes for data cabling, though network changes are more forgiving because a practice can work from a temporary router for a few days if the schedule says so.
5. Temporary accommodation, in practice
A temporary operatory has a shorter equipment list than a permanent one but the same essential requirements. It needs a chair, a delivery system, an assistant's position, a light, suction, a hand-wash point, and a way to move contaminated instruments out and clean ones in. A sink is not optional. A place to store sterilized instruments so they stay sterile is not optional. Where a practice cannot provide those things in a temporary room, that room is not a treatment room, whatever the schedule says.
Patients will notice the change whether or not it is explained. A short note before the appointment about the entrance, the parking or the temporary waiting area removes most of the friction, and front desk staff should be briefed so the answer is the same whoever is asked.
6. Containment: dust, noise and contaminated air
Renovation in an occupied clinic is a containment problem before it is a construction problem. Dust barriers keep gypsum dust out of working rooms, but they also keep it out of the return air path that serves the whole suite. Negative air pressure in the work zone, sealed doorways on the working side, and a route in and out of the site that does not cross the patient side of the practice are all standard measures once the work zone is defined. Duct openings that are going to be re-used should be sealed before demolition starts rather than after, because once dust is in the ductwork it is very hard to get out.
Noise is harder to contain than dust. A grinder or a hammer drill carries through any stud wall, and it will carry through the treatment room on the other side. Noisy work belongs outside clinical hours wherever the programme allows it, and where it cannot be moved, the working rooms nearest the site are the ones to schedule lightly that day.
7. Can inspections be booked around clinic hours?
Most visits that need a person on site can be arranged at the start or end of the clinical day, or on a day the practice is closed. What cannot always be moved is the sequence: some elements must be seen before they are covered over, so if a wall is closed before the visit happens, the visit cannot confirm what is behind it. The practice and the contractor therefore agree which dates are fixed and which dates can drift with the clinical schedule, and the fixed ones go into the practice diary in the same way as a patient slot. More on arranging those visits is in the note on inspection timing. Where the electrical work is being certified, the same logic applies to the trades: a certificate can be issued on a Friday for the work done, but the inspection it depends on has to have happened before the wall closed.
8. What does the schedule look like when rooms, not the whole clinic, are moving?
Rooms move one at a time, in the order that costs the practice the least chair time. That means the least-used room goes first, and the rooms that carry the heaviest booking load wait until the practice has enough slack in the diary to absorb their loss. The sequence is not just the contractor's preference; it is a clinical decision about which days the practice can afford to run short.
| Phase | Clinical position | Typical duration driver |
|---|---|---|
| One room handed over | Other rooms carry the full schedule | Number of working chairs remaining |
| Service shutdown for a shared wall | Affected rooms out of service | Plumbing and electrical re-routing |
| Sterilization corner moved | Reprocessing runs from temporary set-up | Separating dirty and clean flow |
| Room returned | Rebuilt room re-opens to patients | Commissioning before clinical use |
The table is not a timetable. It is a list of the four points at which the clinical position changes, and a schedule that does not name those four points is not a phasing plan yet.
9. Projects that have done this
Renovations of occupied practices are the projects where phasing, containment and clinical continuity are worked out in detail. A selection of them, alongside new-build work, appears in the archive of renovation project examples.
Once the rooms are back and the new layout is settled, the question that tends to arrive late is whether the new treatment rooms sit where the old walls allow them to. A plan that fits only if a bearing wall has gone is a longer, more expensive job than one built to fit the structure already there. The constraints of that approach are described under layout within existing walls, and it is worth settling before a single partition goes up.
The limit of what any plan can promise is at the point where the programme meets the building. The phasing can be drawn, the shutdown windows can be named, and the containment can be specified, but the discovery of what is inside an older wall belongs to the day the wall comes down. The practice that has already decided how it will respond to that day is the practice that stays open.
For practices weighing the regulatory obligations that sit underneath a renovation, the ADA's practice management resource is the place to start.
